Skip to main content

Bottlenecked: Supply Constraints Are Likely to Slow the U.S. AI Buildout

Mauri Hall, Economist

Date Published: July 16, 2026

Download

Share:

Highlights

  • The planned AI buildout represents one of the largest investment cycles in recent U.S. history, but constraints in power access, equipment availability, labor supply and permitting are slowing the pace at which new data center capacity can be brought online.
  • Commodity disruptions linked to the Strait of Hormuz are adding to the cost pressure through semiconductor and copper supply chains. Helium is a critical input for semiconductor fabrication, while sulfuric acid is used in copper extraction, raising input costs for AI infrastructure.
  • Our forecast already takes a cautious view of AI-related investment, but even that outlook could prove optimistic if these constraints intensify.

Investment in artificial intelligence (AI) has become one of the most important drivers of the near-term U.S. economic outlook. Hyperscalers—the firms leading the AI buildout—have committed to spending over $750 billion in 2026 and $900 billion in 2027 to expand computing capacity, eclipsing even the dot-com cycle in GDP-percentage terms (Chart 1).

The economic impact of this spending will depend not only on how much is invested, but on how quickly the inputs needed to build and operate data centers can be secured. Data centers require large amounts of electricity, specialized equipment, advanced semiconductors, skilled labor, and regulatory approval. Constraints in any one of these inputs can delay deployment even when financing is readily available.

This bar chart compares annual investment spending, and projected spending on artificial intelligence infrastructure with spending during the dot com investment cycle. Spending by hyperscalers is projected to approach $700 billion annually in 2026 alone, exceeding investment levels observed during the dot-com era when measured as a share of GDP. The chart highlights the unprecedented scale of planned AI-related capital expenditures. Data sources: BEA, TD Economics. This bar chart compares total U.S. investment in 2025 to projected total investment in 2026 with the share of investment in both years given in green while the non-AI investment share is given in grey. The chart shows projected investment in 2026 is larger than actual investment in 2025 in percentage point terms and the AI share of that investment is also larger than 2025 in percentage point terms. Source: BEA, TD Economics.

Several of these constraints are already binding. Limited grid access, long equipment lead times, labor shortages and permitting challenges are slowing the pace at which planned capacity is brought online. Disruptions in the Middle East affecting semiconductor and copper supply chains are adding further cost pressure.

Together, these factors suggest that the physical buildout of AI infrastructure is likely to proceed more slowly and at higher cost than implied by a naïve extrapolation of announced investment plans. While still too large to ignore (Chart 2), our forecast takes a cautious view of AI-related investment, incorporating only 60%-70% of announced spending into our outlook for business investment, once accounting for shortages, delays and higher input costs. Even that outlook could prove optimistic if constraints intensify.

Electricity Access Can Take Up to Seven Years

The most important bottleneck for the AI buildout is difficulty connecting data centers to energy infrastructure. Despite the surge in planned investment, only five of the sixteen gigawatts (GW) of data center electricity capacity announced for 2026 delivery is currently under construction.1 A quarter of the 140 projects scheduled for completion by the end of 2026 have not disclosed a power access strategy.2

Grid connection wait times in major U.S. markets range from three to four years and can run even longer in saturated geographic areas. The connection wait time in Northern Virginia, for example, is currently seven years.3 This suggests that construction completion and operational readiness may increasingly diverge. Facilities may be physically completed before sufficient electricity is available for full operation, delaying the conversion of investment spending into usable capacity.

Some firms have sought to sidestep the lengthy wait times for grid connection by investing in on-site power generation powered by natural gas turbines. However, global turbine orders reached 110 GW by the end of 2025, while manufacturing capacity tops out at 60-70 GW, constraining this strategy.4 As our recent report noted, one of the three dominant manufacturers of gas turbines—GE Vernova—is sold out through 2028. As a result, on-site generation is unlikely to fully offset broader grid-access constraints.

Another bottleneck lies in the equipment required to expand grid infrastructure. According to Wood Mackenzie, price levels for power transformers have increased by 77% relative to their pre-pandemic baseline.5 Imports of high-voltage transformers have increased sharply in recent years as domestic U.S. production has been unable to keep pace with demand.6 This is a crucial chokepoint as lead time ranges between two and five years. Even where generation capacity exists, long transformer lead times can delay the delivery of electricity to new facilities. This reinforces broader power-related bottlenecks and extends the timeline for capacity expansion.

Skilled Workers Are in Short Supply

Even where components are available, they must be installed by specialized workers, which are increasingly in short supply. Electricians serve as a canonical example since electrical systems account for between 45% and 70% of total data center construction costs.7  Expanding the supply of electricians requires four to five years of apprenticeship and training, limiting how quickly the workforce can respond to rising demand. The constraint is compounded by retirements, with roughly 30% of current union electricians at or near retirement age.8

Demand and supply for other skilled trades has similar characteristics. Demand for HVAC engineers, for example, has risen sharply since 2022, outpacing supply.9 For skilled trades workers as a whole, the time-to-hire is now longer than for office-based professionals.10 Many data centers are also being built in lower-cost power markets where local pools of skilled labor are limited. Firms have responded by offering wage premiums of 20%-30%. The result is a labor constraint that raises costs and extends construction timelines.

Local Opposition and Permitting Challenges Are Becoming More Significant

Local approval is becoming another constraint on the AI buildout, even for projects with access to power and labor. This is particularly true in high-density markets. In the first quarter of 2026, at least 75 projects representing $130 billion USD in potential investment were delayed or blocked due to local political resistance, matching the scale of all of 2025 in just three months.11

Resistance is driven, in part, by concerns about electricity prices and infrastructure burdens.12 The opposition has become increasingly organized and is shaping regulatory and legislative environments in some markets, including through the rollback of tax incentives that had supported project economics.

Project tracking data shows that permitting plays a significant role in delaying construction. According to January 2026 data from PJM Interconnection, permitting accounted for 29% of milestone change requests for projects under construction, making permitting one of the leading causes of project delays. Moreover, projects in PJM’s queue took, on average, more than three years to reach interconnection service agreements.13, 14

Taken together, the evidence points to a slower, more expensive AI buildout than announced investment plans imply, making the most optimistic growth forecasts harder to justify and supporting our more cautious outlook.

Canada’s Helium Opportunity



Higher helium prices may also create opportunities for regions with large undeveloped reserves. Canada holds the world’s fifth-largest primary helium reserve potential, primarily located in Alberta and Saskatchewan (Chart 3).15 Helium from these provinces’ is highly concentrated with an average of 1% concentration versus the global average of just 0.1% (Chart 4).16

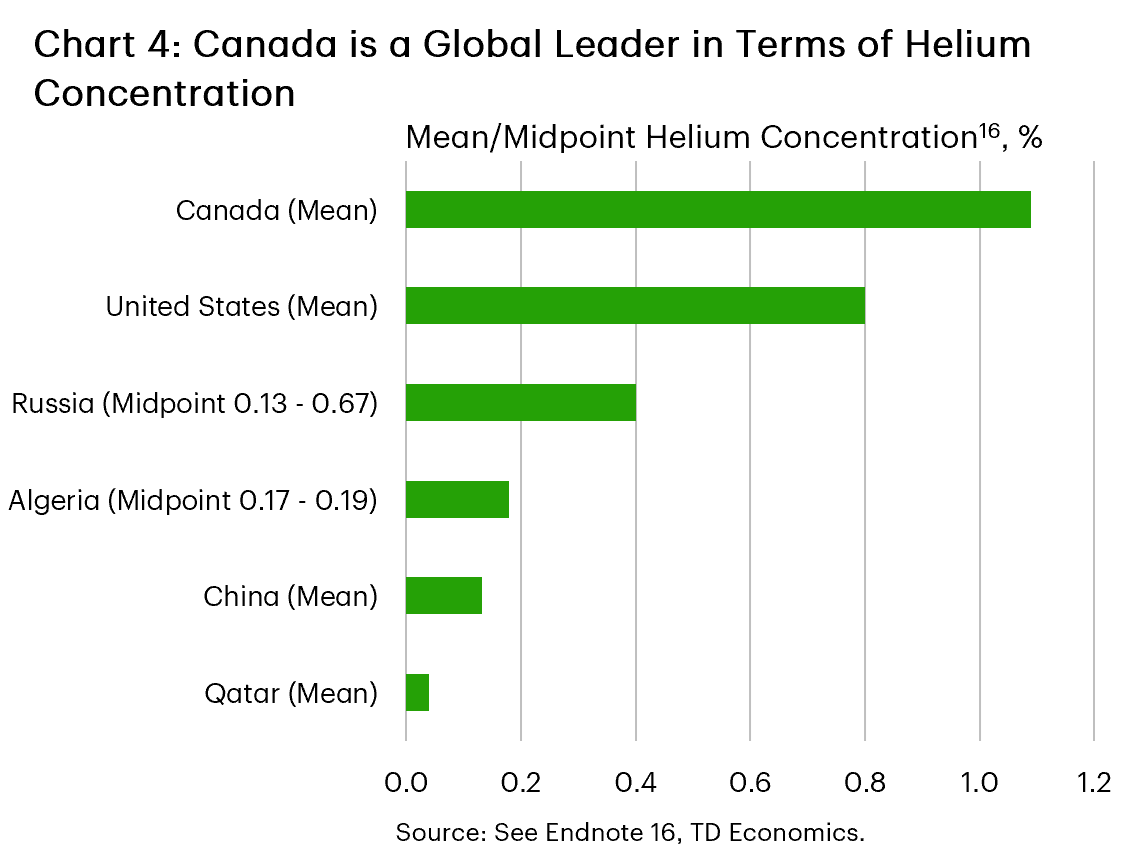

High concentration implies cost savings. What is more, the deposits are co-located with nitrogen rather than methane, resulting in lower associated emissions during production than competing sources. This insulates the Canadian Helium industry from fossil fuel price volatility. Given Saskatchewan’s objective of expanding Helium exports to supply 10% of the world’s usable Helium by 2030, the next three to five years represent an opportunity for helium producers to increase their footprint in the global market.17

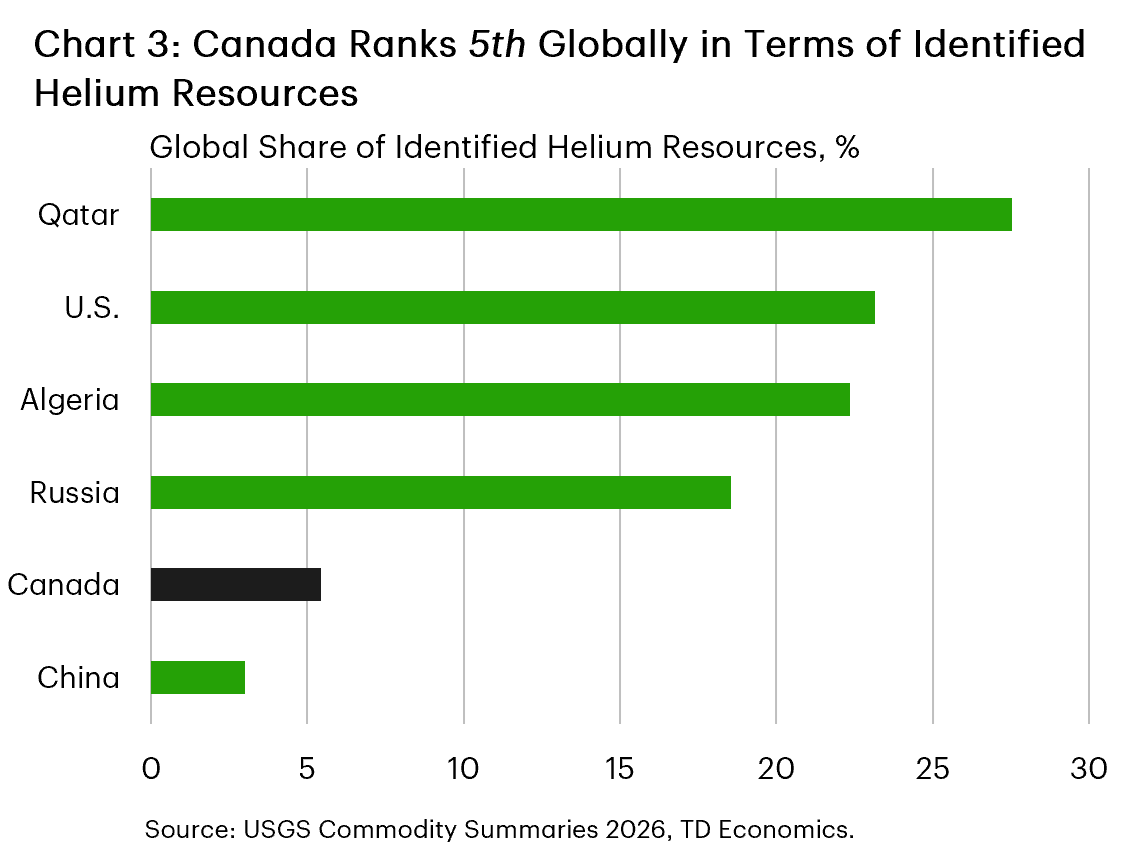

This horizontal bar chart shows identified helium in the top 6 countries as a percentage of global identified helium with Canada in 5th place. The ranking in order is Qatar, U.S., Algeria, Russia, Canada and China. Data sources: USGS Mineral Commodity Summaries 2026, TD Economics This bar chart compares average helium concentrations in selected producing regions and countries. Canada has the highest concentration among those shown, averaging approximately 1 percent helium content. Other jurisdictions, including the United States, Russia, Algeria, China, and Qatar, show lower helium concentrations. Higher helium concentrations generally reduce extraction costs and improve commercial viability. Data Source: various government agencies, TD Economics.



In addition to these domestic constraints, global supply shocks such as the recent Strait of Hormuz commodity flow disruption are driving up costs for essential inputs.

Strait of Hormuz Disruptions Further Raise Costs

Strait of Hormuz-related disruptions have increased cost pressures through two distinct channels. The first operates through semiconductor supply chains, where helium shortages have raised fabrication costs. The second operates through copper supply chains, where sulfuric acid shortages have increased pressure on copper production and pricing. Both channels add cost pressure to the AI buildout.

Helium is a critical input in semiconductor fabrication and has few practical substitutes. As a result, disruptions to supply can raise production costs and constrain chip availability. The damage to Qatar’s Ras Laffan Industrial City reduced global helium supply by approximately one third, and helium spot prices rose materially in the weeks that followed. Available supply has also been rerouted through longer shipping routes, increasing transit times, increasing shipping cost and reducing delivered volumes as liquid helium evaporates in transit. Together, these factors have increased the cost of semiconductor production, raising the cost of servers and other equipment used in AI infrastructure.

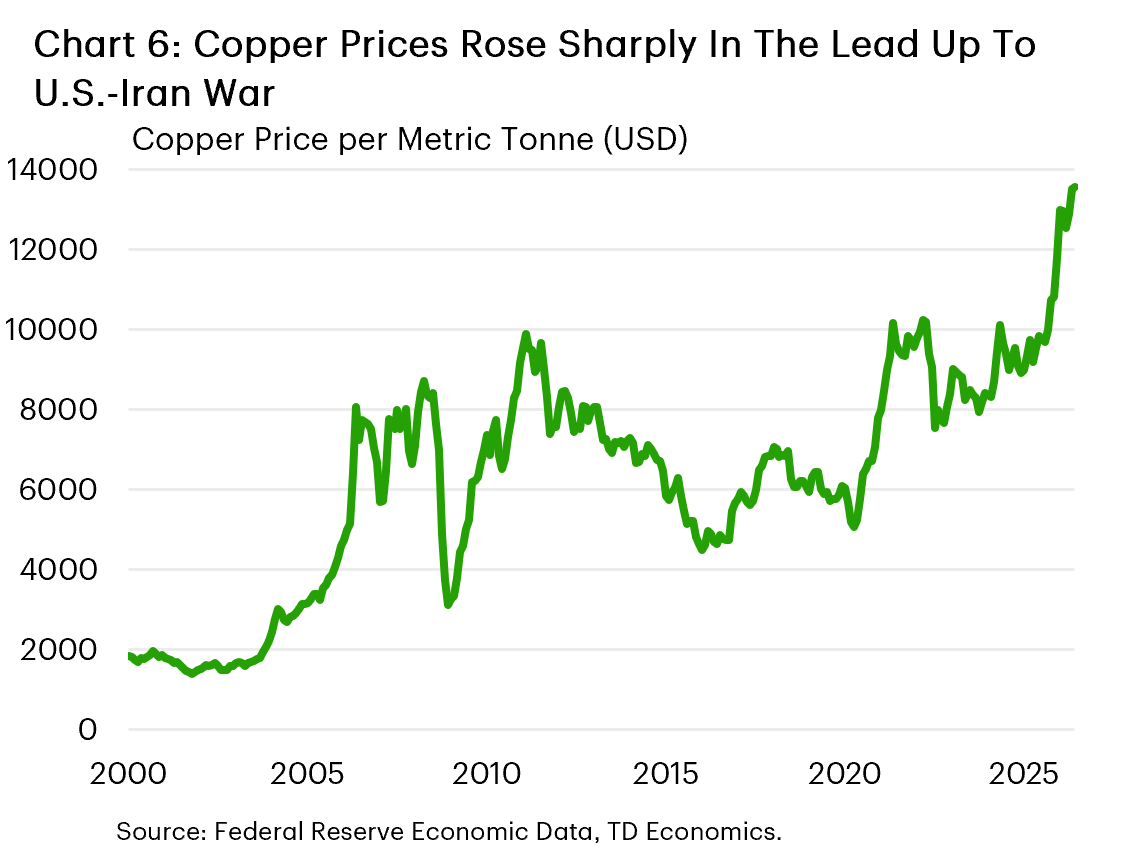

Sulfuric acid is another key commodity affected by the Strait’s disruption (Chart 5). Sulfuric acid is required to extract copper, so tighter acid supply is likely to keep copper prices elevated. Copper prices had already risen sharply before the Iran-U.S. conflict (Chart 6).

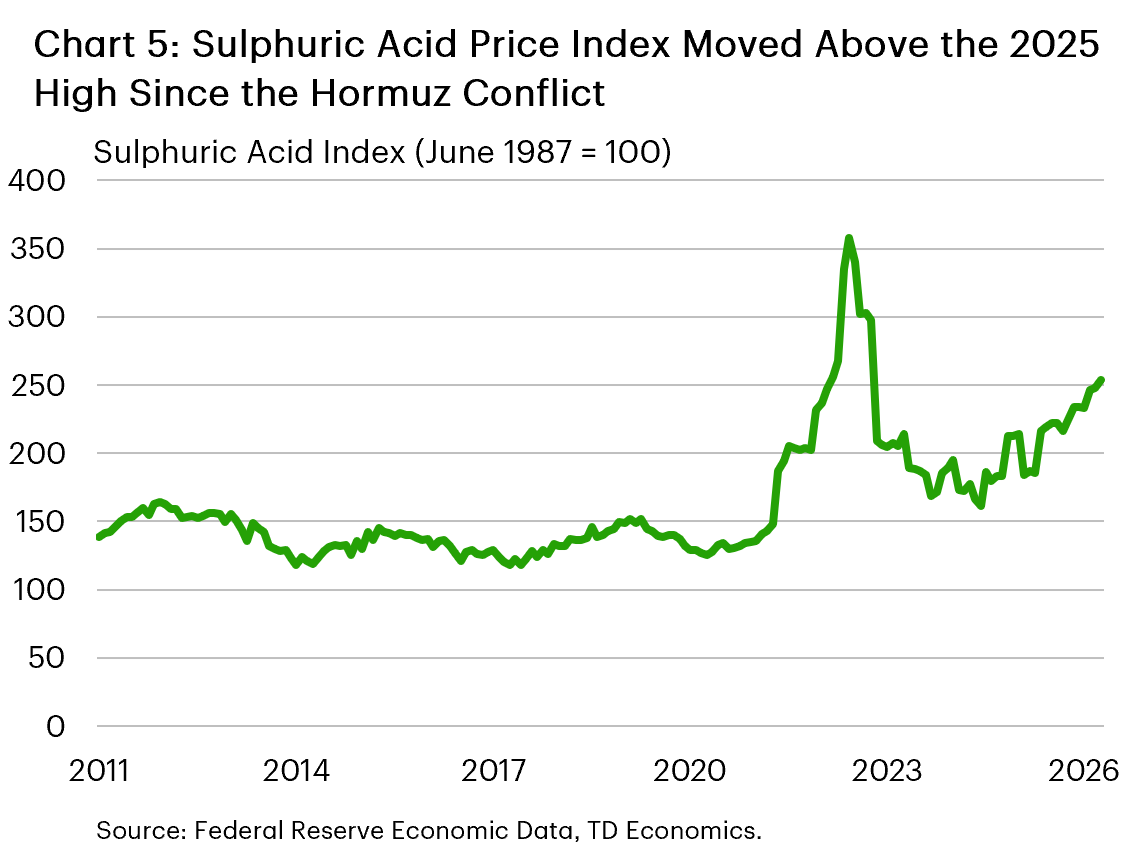

This line chart shows the price of sulphuric acid over time, displaying a sharp increase during Covid which comes back down near pre covid levels and another increase under weigh since 2024 which persists to the present. The chart is monthly. Data sources: FRED, TD Economics. This line chart shows the copper price yearly, showing a steady increase in copper prices since 2007, but a sharp increase since 2024. Data sources: FRED, TD Economics.

China’s decision to restrict domestic sulfuric acid exports has further tightened supply, with estimates suggesting that roughly 200,000 tons of Chilean copper production are at risk.  Because large-scale data centers require substantial quantities of copper for wiring, distribution systems and supporting electrical infrastructure, sustained copper-price increases will directly raise construction costs.18

Bottom Line

AI investment is shaping up to be one of the largest private capital spending cycles in modern U.S. economic history. That scale should provide meaningful support to U.S. business investment, even under conservative assumptions. Still, turning planned spending into completed projects requires access to electricity, specialized equipment, skilled labor and regulatory approvals that are becoming harder to secure.

Evidence from power markets, equipment supply chains, labor markets and permitting data points to a slower, more expensive AI buildout than announced plans imply. Commodity disruptions affecting semiconductor and copper supply chains only add another layer of cost pressure.

Our baseline forecast reflects both sides of this story. We incorporate 60% to 70% of announced AI-related spending into our outlook for real U.S. business investment over the next two years to account for shortages, delays and higher input costs. That still leaves AI as an important source of growth, but with benefits that are likely to arrive more gradually than the scale of planned spending alone would suggest. If bottlenecks intensify, even this more cautious outlook could prove optimistic.
